Before & After Coorparoo, Brisbane

Before & After: Coorparoo Queenslander Raise and Build-Under

The same house on the same block, from the original 1920s Queenslander through to a completed two-level home. 3.35 m raise. 112.5 m² enclosed build-under. $331,510 build-under.

📷 Visual proof

Same corner, years apart

Three moments from the same project: original condition, mid-raise, finished.

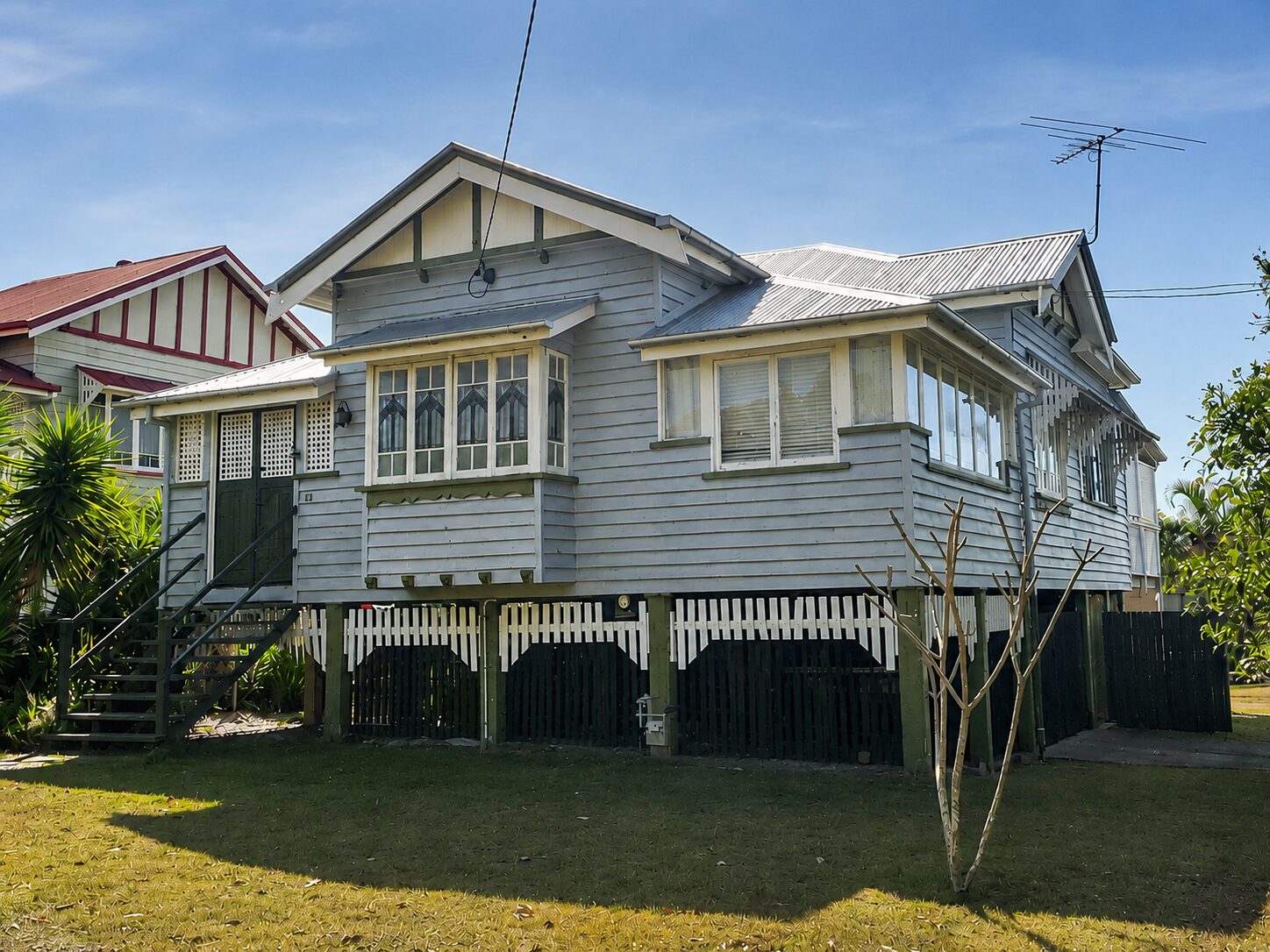

The Coorparoo Queenslander in original condition: 1920s weatherboard on short stumps
Before

Original Queenslander

1920s weatherboard on short stumps (~0.6 m). Single storey. Limited headroom underneath.

The Queenslander raised to 3.35 m: suspended on temporary steel and timber crib supports
During raise, 2018

Suspended at 3.35 m

The house raised to 11 feet on temporary supports. The build-under took shape underneath.

The completed Coorparoo Queenslander: two-level home after raise and build-under
After

Completed build-under

Two-level home. 112.5 m² enclosed build-under. 2.9 m ceiling height. Same block, same house.

See all project photos

The complete photo set, organised by stage.

Browse all photos →

🛣️ Stage by stage

The transformation, stage by stage

Every major stage from original house to completed build-under.

The original Coorparoo Queenslander before raising
1

Pre-2018

Original house

1920s Queenslander on short stumps (~0.6 m), single storey with weatherboard cladding. The block had potential, but the house had limited headroom underneath, not enough for anything useful.

The Queenslander raised to 3.35 m on temporary crib supports
2

2018

Raised on temporary supports

The raise contractor used hydraulic jacks at ~30 positions to lift the house to 3.35 m under floor level, or 11 feet. The house sat on temporary steel and timber crib supports for 11 days while the permanent subfloor was installed below.

Foundation and slab work underway on the new Queenslander ground floor
3

2018-2019

Slab and subfloor

Once the house was lowered onto its permanent subfloor, the ground floor build began: earthworks, termite barrier, raft slab design and pour. The engineer's specification on shale with active ground drove the reinforcing requirements.

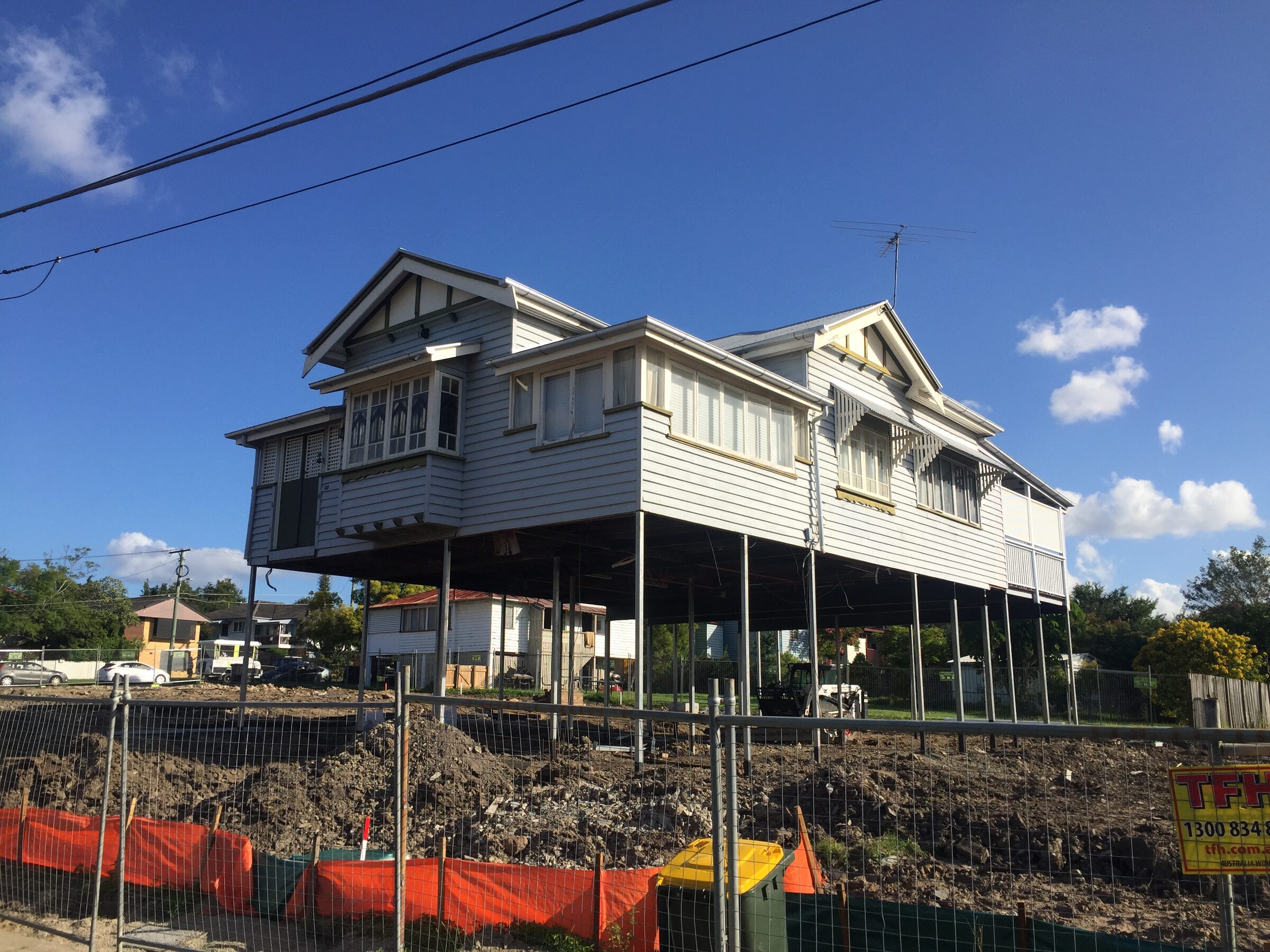

Framing and services rough-in during the Queenslander build-under
4

2019

Framing and services

External and internal wall framing formed the new ground floor rooms. Rough-in of all services followed, electrical and plumbing, before any walls were closed in. Each stage required certifier sign-off before proceeding.

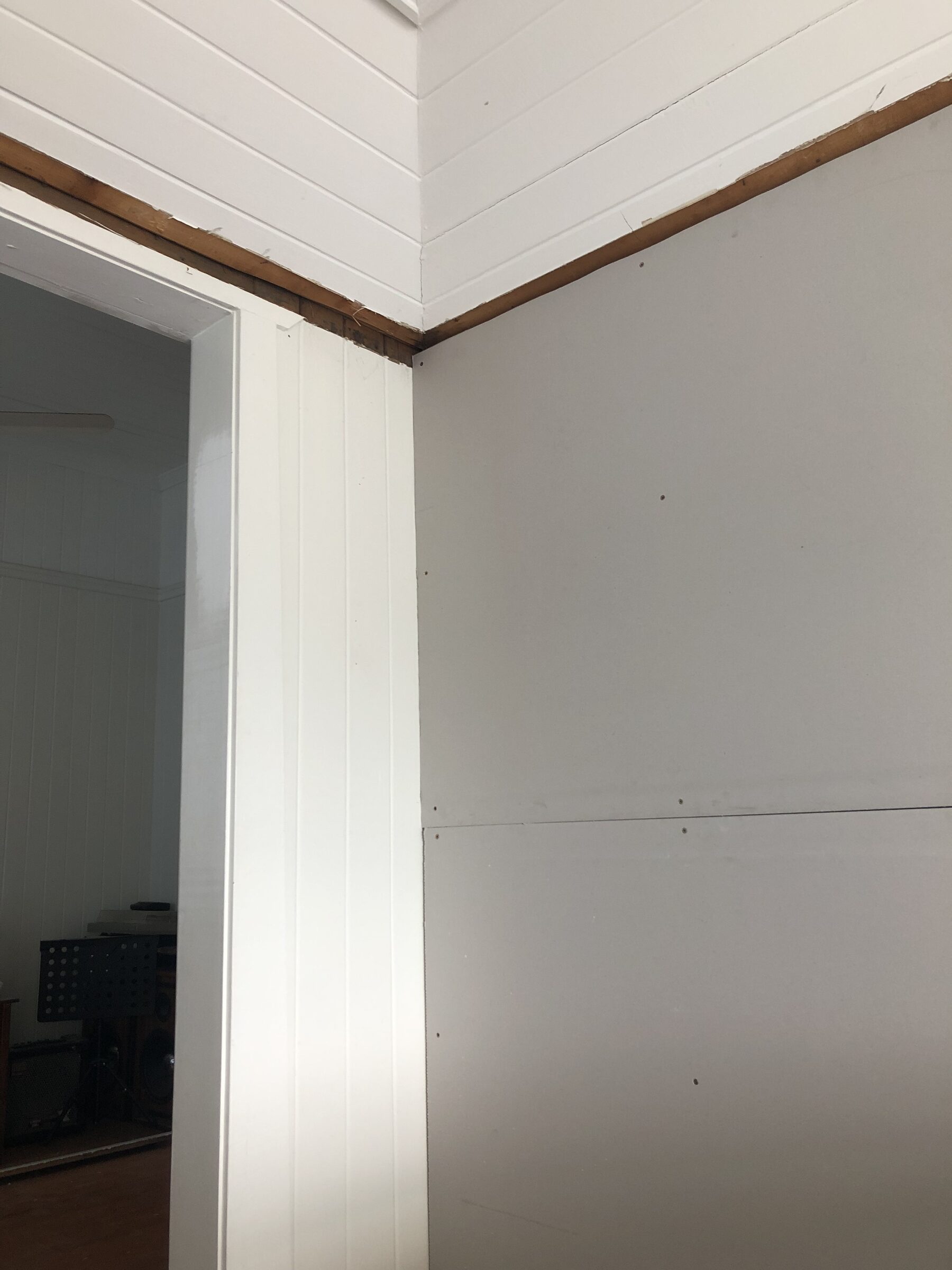

Interior finishing and linings in progress: build-under nearing completion
5

2019-2020

Lining and fit-out

Insulation, plasterboard, bathroom tiles and fit-out, polished concrete flooring and painting all followed. The ground floor went from rough framing to a finished, liveable space.

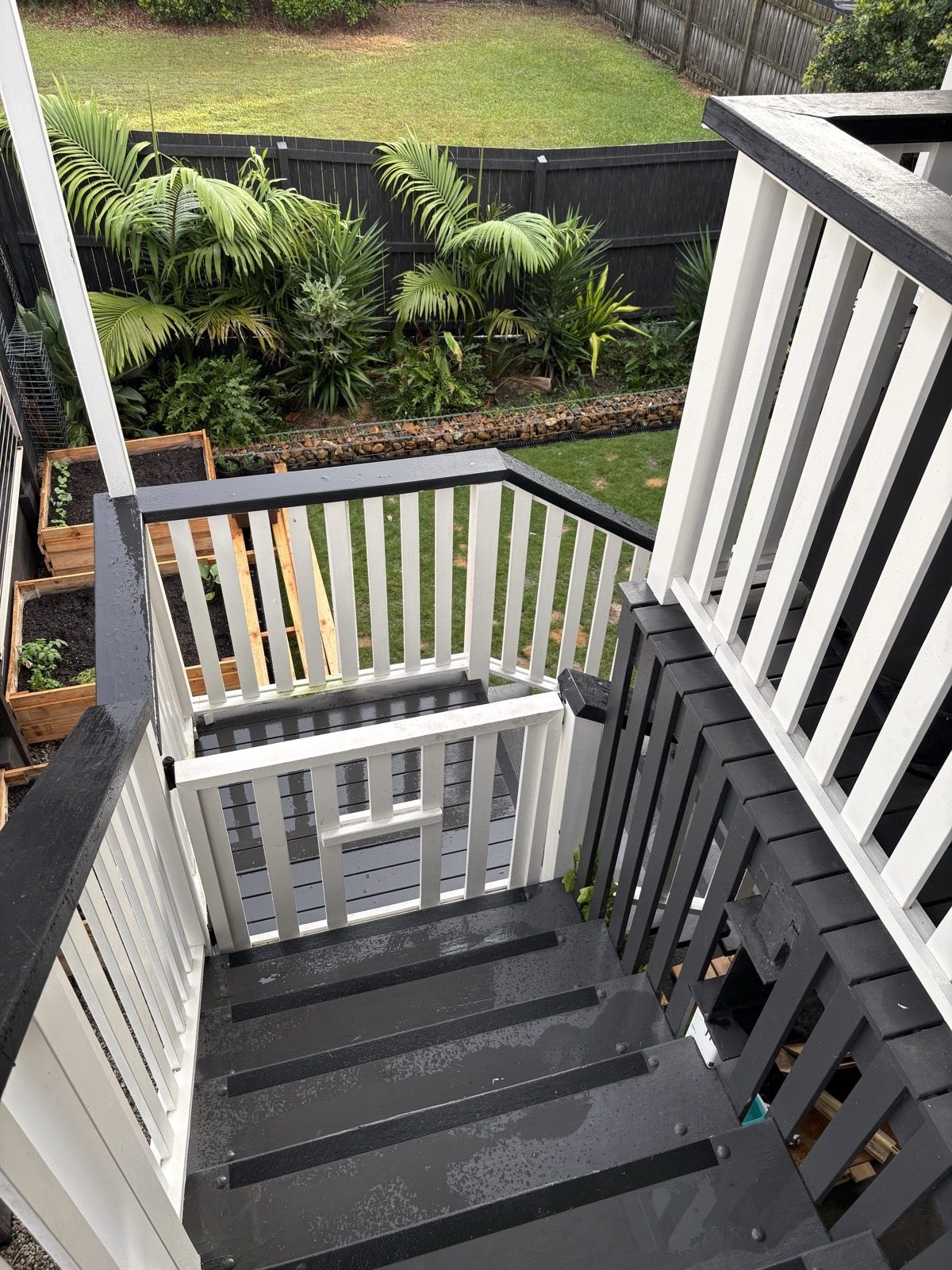

The completed Coorparoo Queenslander after raise and build-under
6

2020

Completed build-under

The same block and the same house, now with a complete two-level home. The enclosed habitable build-under is 112.5 m² of new living space with 2.9 m finished ceiling height throughout. The 1920s character of the upstairs is unchanged.

🏗️ The invisible work

What you can't see in the photos

The visible transformation is the easy part. What determines whether a project like this succeeds is everything that doesn't show up in a finished photo.

Engineering

Structural engineering specified both the permanent subfloor and the temporary works: the lifting system, crib stack design, bracing and connection details. This documentation is what makes a 3.35 m raise safe and certifiable.

Approvals

Development approval from Brisbane City Council (for the change of use and building envelope), building permit, private certifier engagement and the QBCC owner-builder permit. Each took weeks. None is visible in the photos.

Inspection hold points

Each major stage required a certifier inspection before the next could begin: slab reinforcing before the pour, frame before lining, rough-in before wall closure. Missing a hold point means stopping work until it's rectified.

Drainage and services

The raise disconnected and reconnected every service: water, gas, electrical, sewage. Drainage from the new ground floor had to be engineered to tie into the existing sewer. None of this is visible in a finished photo.

Waterproofing

Wet areas (bathroom, laundry) required membrane waterproofing before tiling, with the certifier signing off at the wet area membrane stage. Getting this wrong creates problems that don't show up for years.

Trade sequencing

Electrical rough-in must happen before plasterboard. Plumbing rough-in before slab. Insulation before lining inspection. The sequence is unforgiving: one trade out of order can delay everyone else.

Plan with the real figures

Get the Build-Under Budget Toolkit

The Coorparoo line items pre-loaded as a worked example. Enter your own quotes alongside the real figures paid, add line-level contingency and catch surprises before they happen.

Get the Build-Under Budget Toolkit ($79)

One-time purchase. 30-day refund.

Or get the free readiness checklist →

Next step

See what the transformation actually cost

Now you've seen the before and after, see the full cost breakdown. $331,510 across 8 categories with notes on items over initial estimates, savings, owner-builder labour and what was outside scope.
