A Coorparoo case study

We raised a 1920s Queenslander in Coorparoo and built underneath it. Here is what we learned.

A first-hand record of one Brisbane owner-builder project: costs, approvals, trade sequencing and the things that did not go to plan. Historical figures, not current rates.

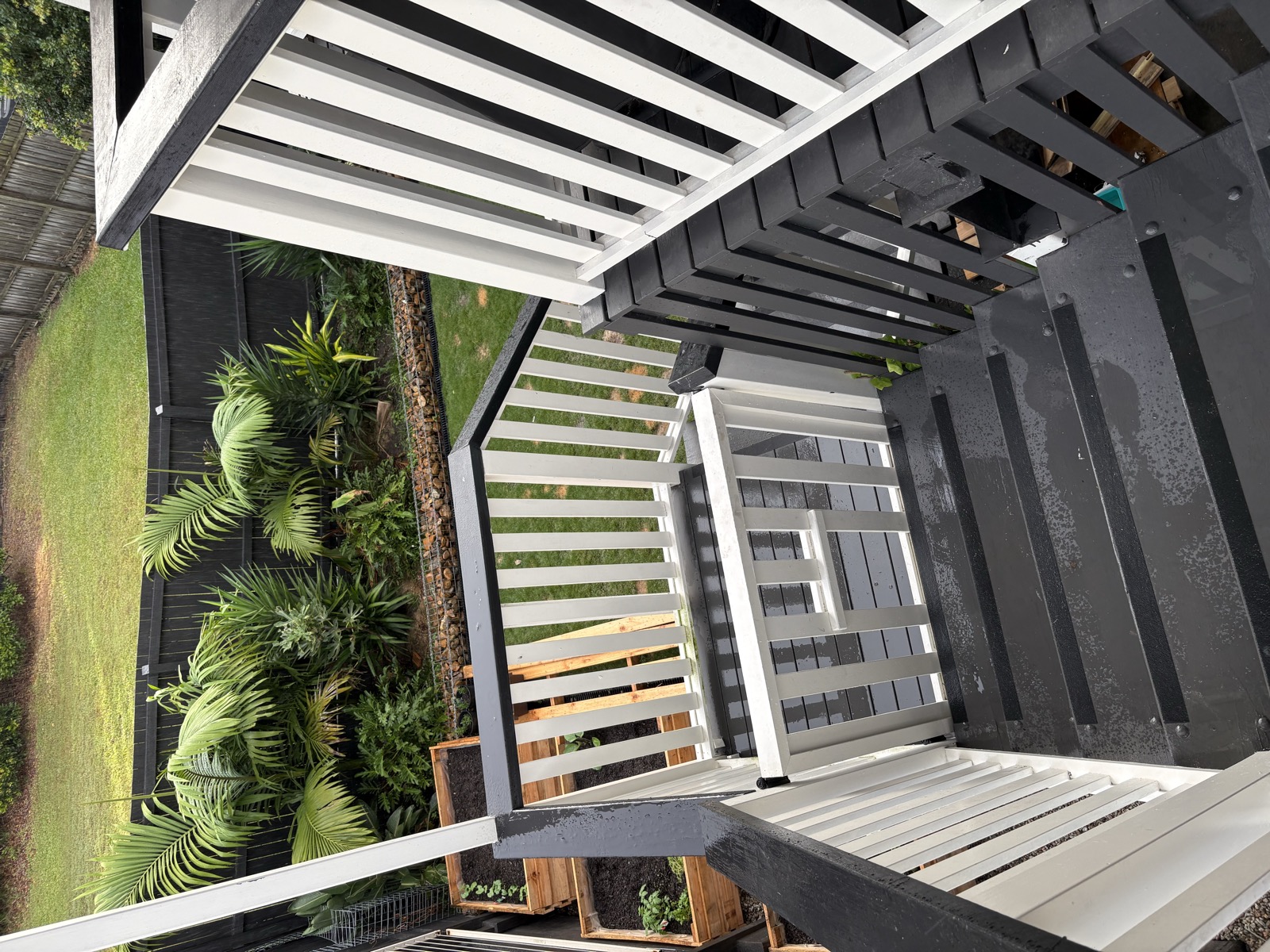

The completed Coorparoo Queenslander after raising and build-under

💰 The numbers

What our Coorparoo project actually cost

Built across 2018-2020 under owner-builder procurement, this project added 112.5 m² of habitable build-under beneath a 1920s Queenslander on Coorparoo shale. These are the historical figures, not current Brisbane market rates.

$331,510

Total build-under

2018-2020 dollars, 8 cost categories

$2,947

Per habitable m²

Owner-builder procurement

112.5 m²

Habitable build-under

New enclosed lower level

18 mo

From engineer to sign-off

Approvals + build window

Scope context

Included

  • Raise, temporary works, subfloor framing
  • Raft slab on shale (112.5 m²)
  • External and internal frame, cladding, roof
  • Services rough-in and fit-off
  • Insulation, plasterboard, paint
  • Bathroom, kitchen, laundry, polished concrete
  • Permits, certifier inspections, owner-builder course

Excluded

  • Upstairs renovation beyond existing
  • Upstairs bathroom rebuild
  • Fencing, landscaping, garden works
  • Furniture, curtains, blinds
  • Solar or battery systems

🏗️ If you want the working files

Optional tools, built from the same project records

Everything above is free. If you'd rather work from the real spreadsheets and templates than build your own, these are the budget model, control checklists and readiness checks from the Coorparoo build. From $79, one-time, instant download.

Browse all tools and templates

One-time payment · instant download · secure checkout via Lemon Squeezy

📖 Recent writing

From the project records

Free for subscribers

Get the free Owner-Builder Readiness Checklist

The owner-builder readiness checklist (PDF), free for subscribers: eligibility, the QBCC course, the documents to have ready and how to check a licence. Plus short, irregular notes from the project records: a specific mistake, a sequencing call, a budget surprise. No marketing, no posting cadence, unsubscribe anytime.

Subscribe and get the checklist

No third parties. Unsubscribe anytime.
